How Efficiently a Sidewalk Violation is Resolved on 6th Avenue in College Point, Queens

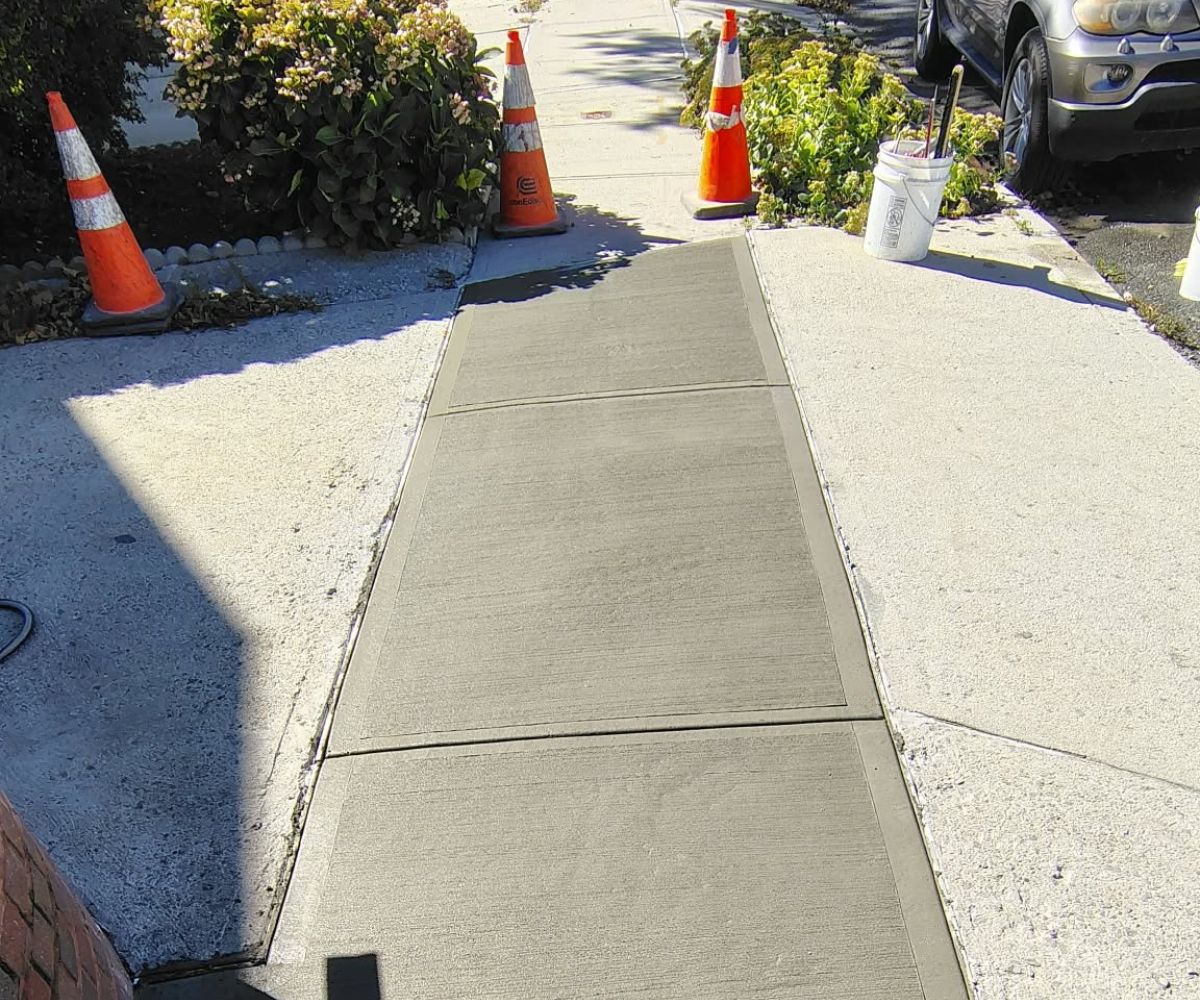

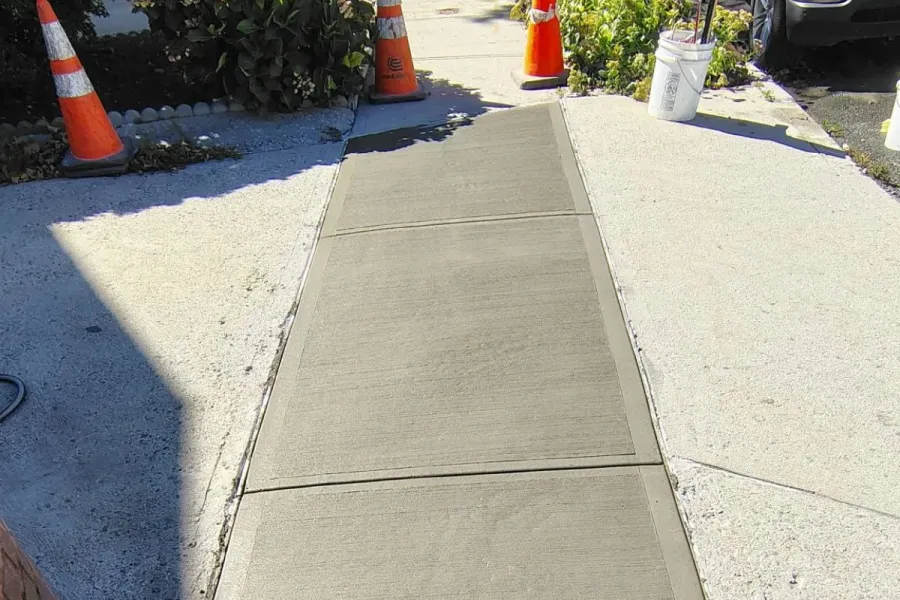

Three newly poured concrete sidewalk slabs with a broom finish and defined joints at 119-40 6th Avenue, College Point, Queens.

Sidewalk damage on a quiet block happens slowly. Nobody notices it year to year, and then the city does. In front of a single-family home at 119-40 6th Avenue in College Point, three slabs had taken decades of winters, rain, and daily footsteps. The wear finally earned a DOT violation and the standard 75-day compliance clock that comes with it. The homeowner wanted it handled properly and quickly, before the city stepped in with its own repair at roughly three times the cost, and the risk of a lien on the house.

Three Slabs, Same Deadline

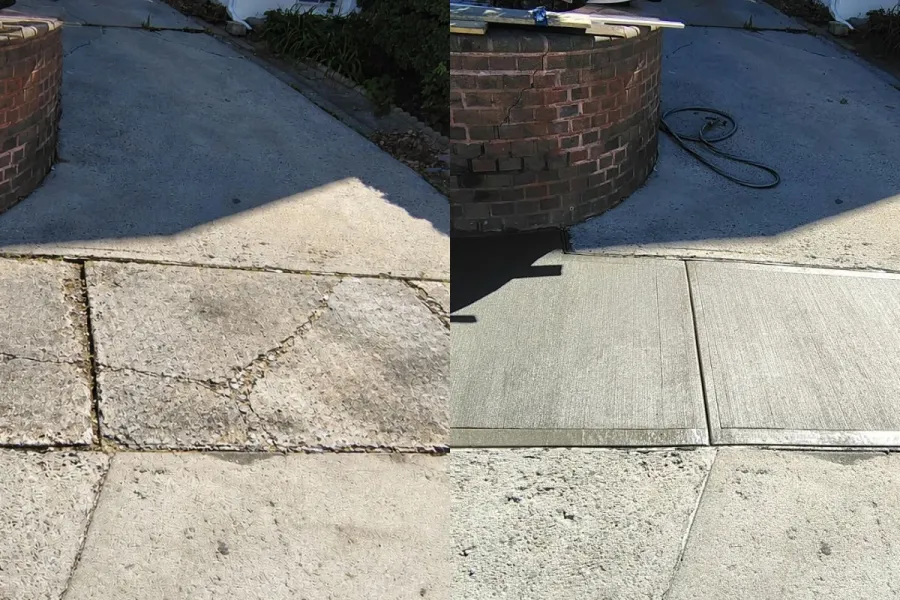

Simulated cracked sidewalk compared with newly replaced slabs outside 119-40 6th Avenue in College Point, Queens.
  • Weather did this, not traffic. There are no delivery trucks crossing this walk. The damage came from freeze-thaw cycles and season after season of rain.
  • A small job carries the same stakes. Three slabs is a short list, but a violation is a violation. The 75-day clock runs just as fast for three as it does for thirty, as the city's rules on owner responsibility make clear.
  • People live on this block. Kids walk to school here and neighbors take evening strolls. The work had to stay quiet and tidy, with a safe path open the whole time.
  • The owner wanted it off their desk. Permits, paperwork, DOT sign-off, all of it handled, not a do-it-yourself runaround.

That called for a compact plan, sequenced well, finished inside the deadline. It is the everyday shape of sidewalk repair in Queens, where most jobs are a handful of slabs in front of someone's home.

The Facts

  • Address: 119-40 6th Avenue, College Point, Queens, NY 11356
  • Client: Residential property owner
  • The house: A two-story, single-family home built in 1930, on a quiet residential block of older single-family houses with local neighborhood traffic.
  • What we did: NYC DOT sidewalk violation removal and full replacement of 3 sidewalk slabs worn down by age, weather exposure, and everyday wear and tear.
  • Filed with the city:
    • Sidewalk Construction/Repair Permit
    • Sidewalk Closing Permit
    • 811 Utility Markout Ticket
  • Permit cost: $70 per sidewalk permit for work up to 300 linear feet, so $140 for the two. The 811 utility markout ticket carries no fee.
  • Total: About $2,700, permit fees included.
  • Days on site: About two, once the permits were secured, scheduled to keep disruption low for the household, pedestrians, and the neighbors.

How We Worked Through It

Walking the property (Days 0 to 1)

It began with the violation notice and a few photos from the homeowner. Our crew from Eden Sidewalk Contractors NYC came out to 6th Avenue, inspected the frontage, marked the 3 failed slabs, and checked the condition of the walk around them. A clear written estimate reached the homeowner within 24 hours, and the permit paperwork started as soon as it was approved.


Filing and the markout (Days 2 to 14)

With the go-ahead, we filed the Sidewalk Construction/Repair Permit and the Sidewalk Closing Permit with NYC DOT and requested the 811 utility markout so every buried line was identified before any digging began. Our team managed each filing directly and kept the homeowner updated. Once the approvals cleared, we booked dates that suited the household and the block.


Out with the old slabs (Days 14 to 16)

On the first construction day the crew lifted out the 3 damaged slabs, built up a properly compacted base, and poured fresh 4000 PSI concrete finished to NYC DOT standards. Safety barriers kept the work zone secure while leaving a clear path for anyone walking by, and each day ended with the site left clean.


Inspection and dismissal (Days 16 to 55+)

After the concrete cured, we arranged the final DOT inspection on the homeowner's behalf. The violation was dismissed and the property returned to full compliance.

What the Block Got

Before the work

  • Three slabs in front of the home were cracked, uneven, and worn thin by age and weather.
  • An active NYC DOT violation set a firm 75-day deadline.
  • The uneven surface was a trip risk for the family, the neighbors, and anyone passing.
  • Two permit filings and an 811 markout for the homeowner to handle alone.

After the work

  • Three smooth, level, DOT-compliant slabs now front the property.
  • The DOT violation is fully closed.
  • The block has a safer walking surface.
  • The homeowner barely had to lift a finger through the whole process.

Why a Small Job Still Counts

This stopped a violation that could have grown into fines, a city-performed repair at triple the price, or a lien against the home. Resolving it inside the compliance window kept the cost near $2,700 and every decision with the homeowner.

On a residential block, the courtesies count. A tidy site, a walkable path each evening, and neighbors who barely noticed work was happening. The two-permit process and the utility markout, the part that puzzles most owners, were handled start to finish by our licensed crew, through to the final DOT sign-off.

The result is a College Point home with a front walk that is safe, solid, and ready for decades more. For a bigger Queens job on the same footing, read how a Flushing two-family home cleared its violation and rebuilt a heaved garage entrance at the same time.

In the Homeowner's Words

"Had a sidewalk violation and needed three concrete slabs replaced outside my house in College Point. The crew handled the permits and got the work done in just two days. They kept everything clean and didn't leave a mess behind. The new sidewalk looks great, and the whole process was easier than I expected. Would definitely recommend them!"

Residential property owner, Queens

Wrapping Up

The violation removal at 119-40 6th Avenue shows how Eden Sidewalk Contractors NYC handles residential jobs where the sidewalk has simply aged out. A fast, honest estimate, permits filed without drama, and two efficient days on site cleared the violation and gave a 1930 College Point home a front walk built for the decades ahead.
